A multi-discipline warehouse expansion combining construction, MEP, technology and a business-critical power cutover under one delivery structure.
The Challenge
Two logistics facilities needed to progress from construction and fit-out into dependable operation without losing control of the interfaces between trades. The scope crossed structural work, sprinklers, lighting, racking, security, networks and office areas. At Milton Keynes, the programme also required a planned shutdown to connect a new power-panel extension while protecting servers, network equipment and warehouse automation.
How We Delivered
One programme across the warehouse

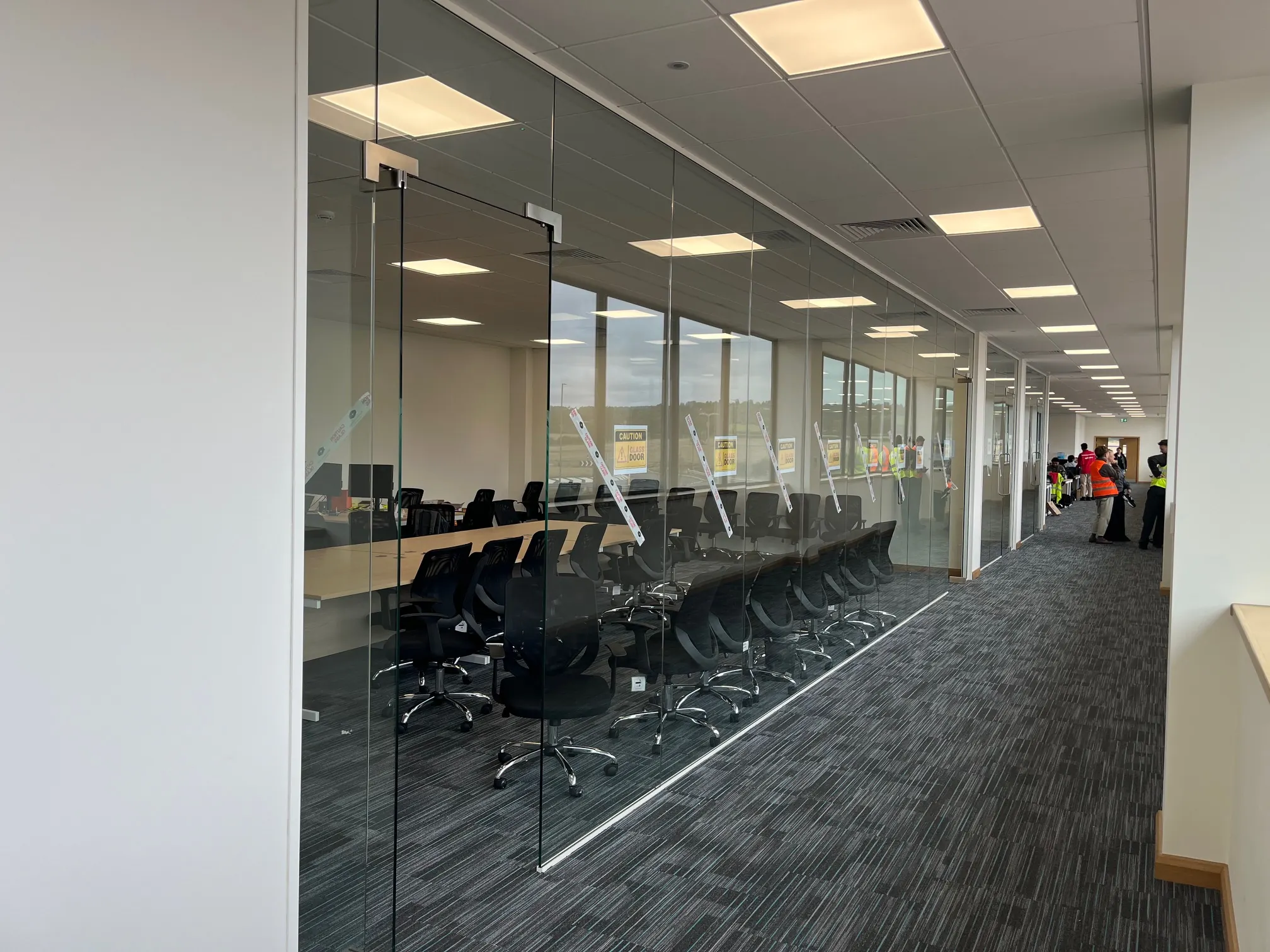

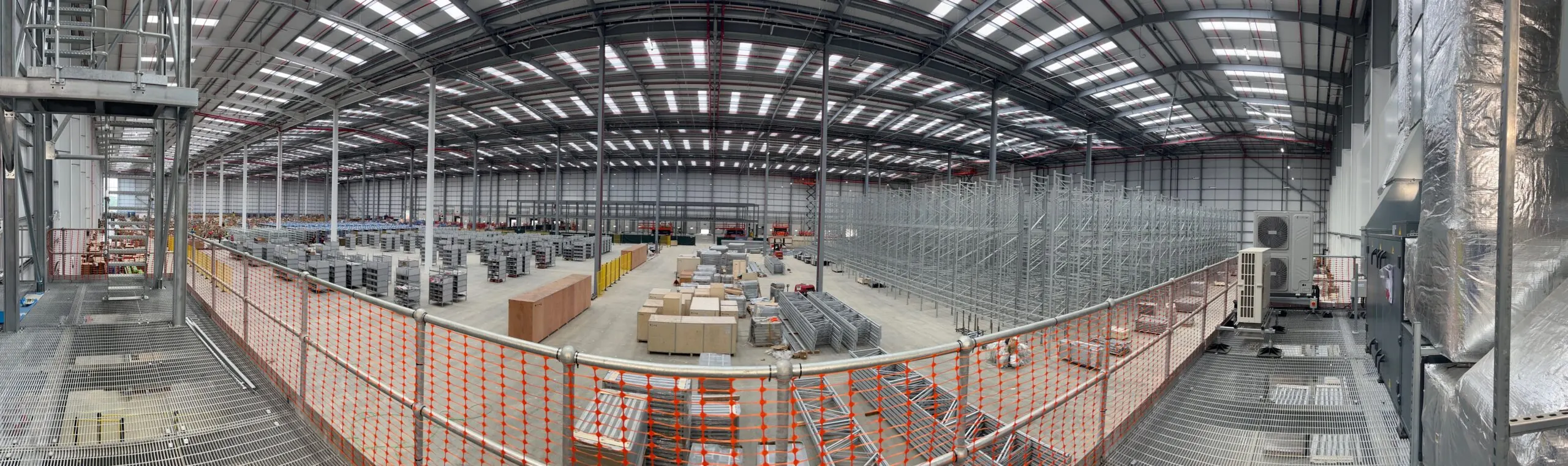

Gadgets Lab coordinated the main-contractor and MEP interfaces, compliance actions, steel platform, mezzanine office, sprinkler changes, lighting, racking and supporting fit-out as a connected delivery plan rather than isolated packages.
Operational technology built into the works
Warehouse-wide CCTV and network coverage were coordinated with the physical layout, power, cabinets, access routes and operational zones so testing and handover could follow the installed environment.
Controlled shutdown and temporary power

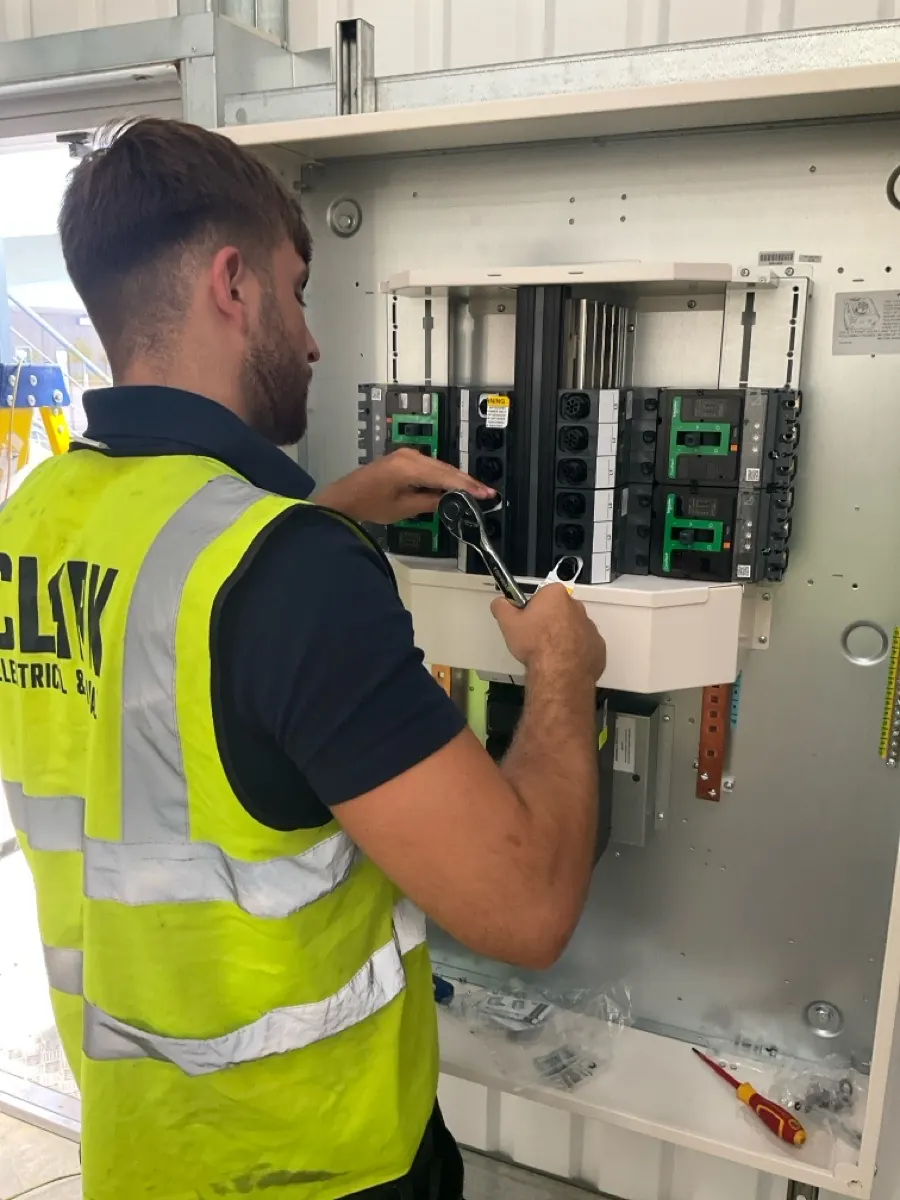

For the MK310 power-panel extension, the team prepared the cutover plan, RAMS, Permit to Work, LOTO, toolbox talk and recovery sequence. Six temporary generators and UPS protection were coordinated around the agreed critical loads.
Live decisions during the change window
When generator protection, UPS runtime and automation recovery behaved differently from assumptions, the project team brought electrical, IT, automation, operations and suppliers into one response, adjusted the recovery order and kept stakeholders updated at each decision point.
Outcomes

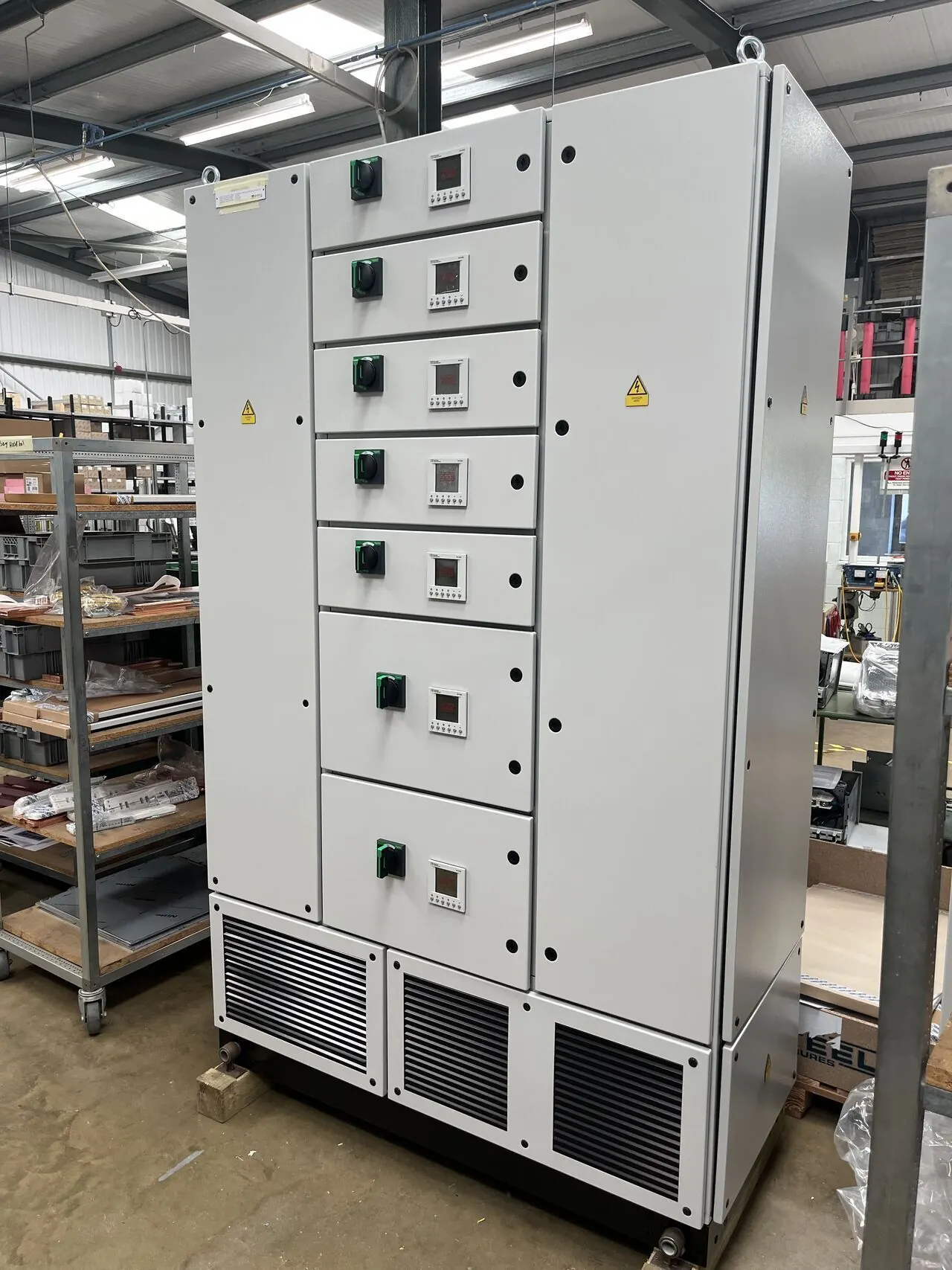

New power-panel extension installed, connected, tested and returned to utility supply
All six temporary generators brought into service for the agreed critical-load plan
Warehouse systems verified by operations at 21:30 following staged restoration
Zero lost-time injury across the shutdown and cutover work
Client Outcome
The completed cutover reached operational acceptance with signed final checks and a documented lessons-learned record. For the wider expansion, the client gained one accountable coordination route across construction, MEP, ICT and operational change—reducing the gaps that typically appear between separate packages.
